Installation Process Ex. 1

Watch the current construction of a 5,400 square foot commercial swimming pool, lap pool, and deep diving pool!
This job began at the end of October and was updated weekly as construction continued through the fall. Updates resumed in the spring as the fall/spring construction schedule was completed for the grand opening in June.

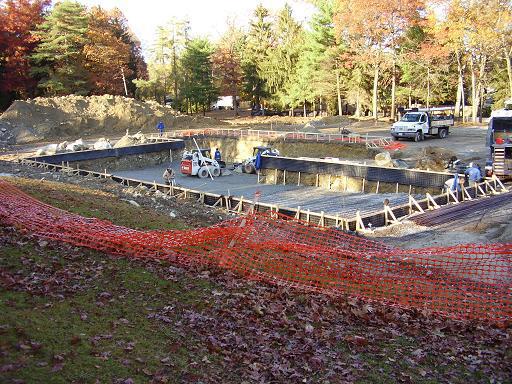

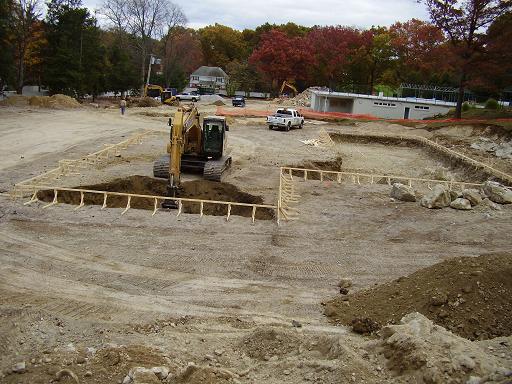

Installation Process Ex. 1 (14)The wooden forms represent the back (or construction side) of the pool. This pool is "Z" shaped with a circular "kiddie" pool off to the side. Some ledge was encountered during excavation along the right side corner.

Installation Process Ex. 1 (18)Crushed stone is spread and compacted throughout the entire floor of the pool. This aids in ground water drainage and results in an even, dry surface to continue construction.

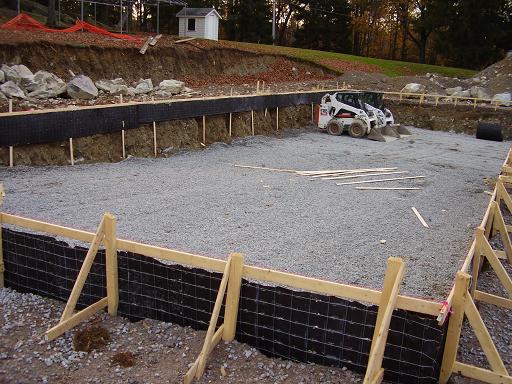

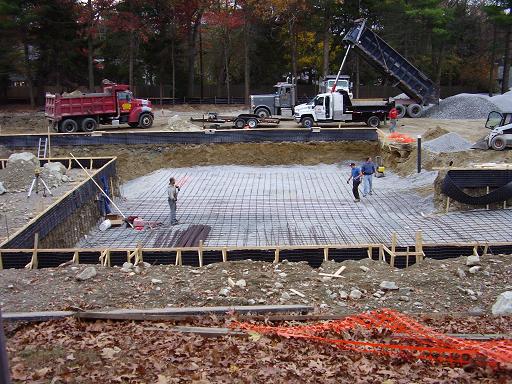

Installation Process Ex. 1 (4)This view shows the graded and compacted stone, and partial steeltex installation prior to steel rebar. Steeltex is secured to the wooden forms where the surrounding dirt grade is lower than the pool.

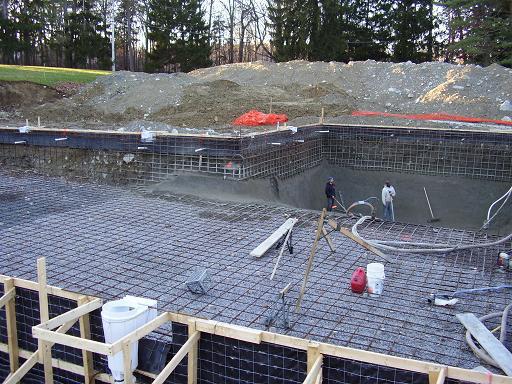

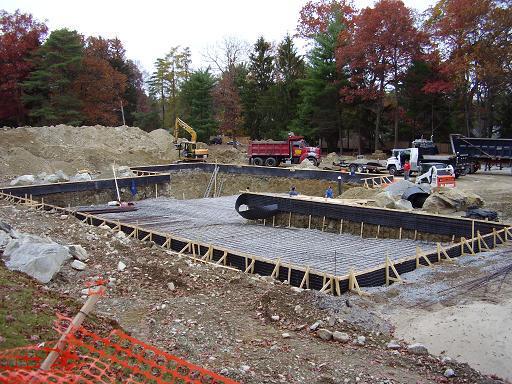

Installation Process Ex. 1 (10)The steeltex is complete except for the entrance ramp area. The steel rebar installation has begun in the shallow end.

Installation Process Ex. 1 (3)Additional crushed stone deliveries as the rebar installation progresses.

Installation Process Ex. 1 (5)Site view as of November.

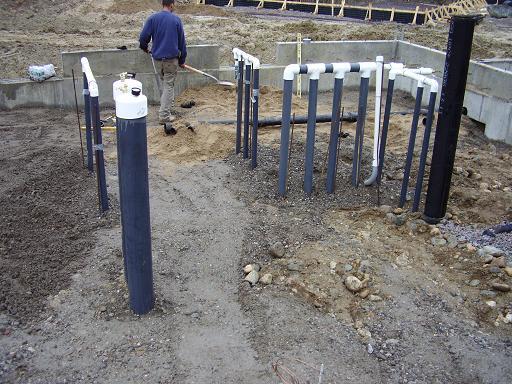

Installation Process Ex. 1 (8)All the plumbing lines must be brought into the filtration equipment building through openings predetermined in the concrete footings and frostwalls. The pipes are backfilled with sand and compacted. Notice that the plumbing lines seem arbitrarily brought up through the filter equipment room floor. They are, however, scaled and brought up in their exact location in the room despite the lack of any filtration system yet...or even room walls!

Installation Process Ex. 1 (12)All plumbing lines are pressure tested prior to any concrete floor pouring. This is accomplished by tying lines together into test stands. Note the pressure gauges on the larger pipes to the left.

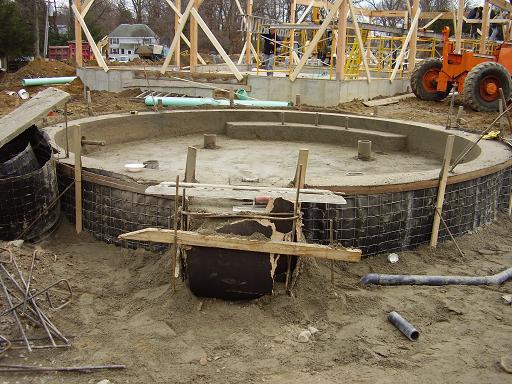

Installation Process Ex. 1 (7)Here you can see the pneumatic concrete installation (or gunite) of the "kiddie" pool. This pool is 1 ft. deep and features three spray jets on the step.

Installation Process Ex. 1 (9)A picture of the hand crafted gunite "kiddie" pool shell.

Installation Process Ex. 1 (1)

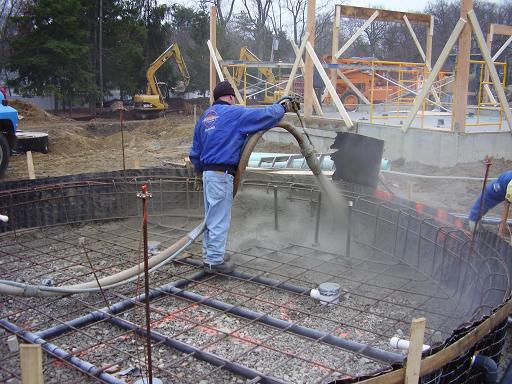

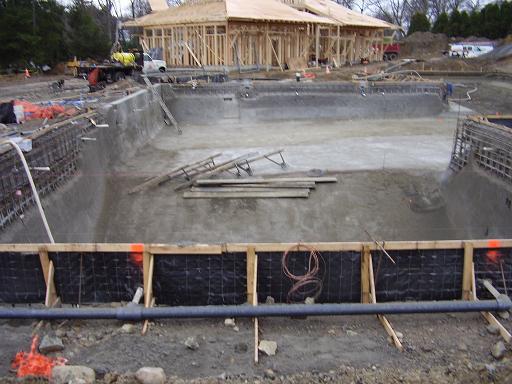

The gunite process of the pool starts in the deep end bowl...

Installation Process Ex. 1 (13)

...then continues up the break into the shallow end floor to set a sturdy foundation for building up the walls.

Installation Process Ex. 1 (16)

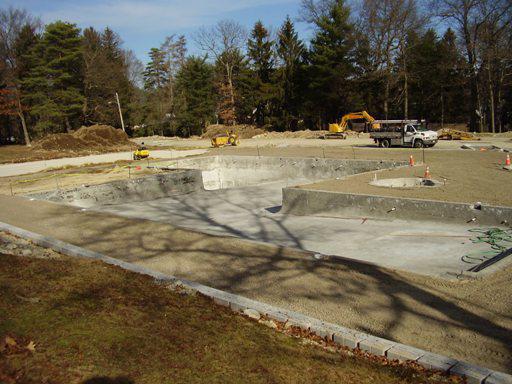

The gunite shell is complete and needs a week to fully cure.

Installation Process Ex. 1 (6)

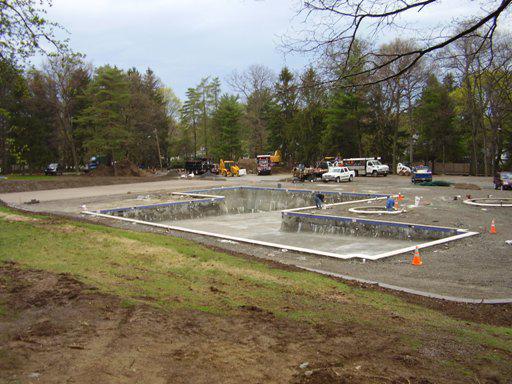

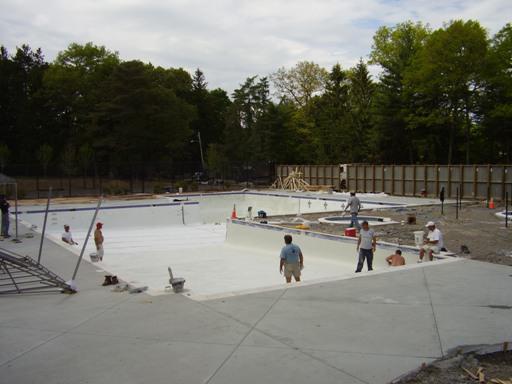

Waterline tile (blue line) is added to the perimeter of the pool.

Installation Process Ex. 1 (2)

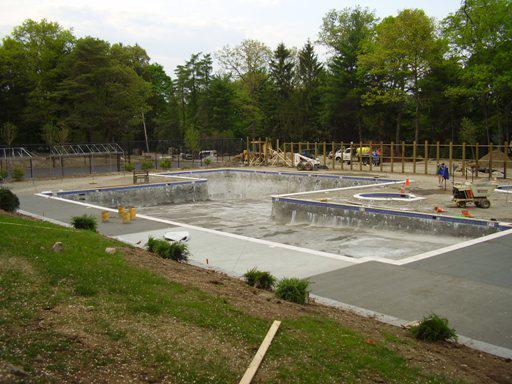

Deck forms are set in place for pouring out the concrete decking.

Installation Process Ex. 1 (11)

The pool then is plastered and ready for water.

Installation Process Ex. 1 (15)

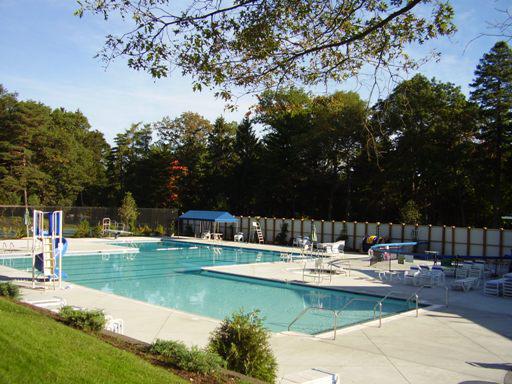

The final process of the pool installation is adding the water and adding the deck features (diving board/slide).
